A commercial lighting concept can look convincing on a rendering and still be difficult to manufacture. The ceiling may require a non-standard length, the interior palette may call for a specific PET felt color, or the lighting brief may specify a particular lumen output, CCT, CRI, voltage, control protocol, mounting detail, quantity, or delivery sequence. Once several of these requirements interact, choosing a product is no longer enough; the project becomes a coordinated development task.
A custom acoustic lighting manufacturer engineers acoustic material, often PET felt, together with the LED, optics, structure, controls, and mounting as one buildable system. The work may involve acoustic material construction, electrical components, suspension, installation access, repeatable production, packaging, and logistics. A typical OEM/ODM program moves from feasibility review and technical drawings to material selection, prototyping, testing, approval, mass production, quality control, and shipping.
This guide explains when custom acoustic lighting for commercial projects is justified, how OEM and ODM responsibilities differ, what information a buyer should prepare, and what evidence to request before production. Buyers comparing standard formats can review available acoustic lighting systems and this guide to choosing acoustic lighting for commercial projects. The goal is to choose the lowest-risk path that satisfies the architectural acoustic lighting brief.
What Is Custom Acoustic Lighting?
A Working Definition
Custom acoustic lighting is the modification or development of an integrated fixture to meet project-specific requirements that an existing product cannot fully satisfy. The customized elements may include the acoustic felt construction, overall dimensions, geometry, LED and optical system, driver and controls, mounting method, finish, branding, documentation, or packaging.
Customization is a spectrum. Changing a standard felt color or suspension length requires less engineering than developing a sculptural form with a new frame, light engine, driver location, and shipping method. The correct level depends on the design objective, risk, quantity, budget, approvals, and schedule.
Standard Modification vs. Full Custom Development
If an existing fixture already meets the ceiling, lighting, material, and control requirements, using it is usually the more efficient decision. It can reduce engineering work, prototype iterations, tooling expense, minimum order quantity (MOQ) pressure, and schedule risk. Full custom development becomes valuable only when the project benefit justifies those additional inputs.
| Development level | Typical changes | Engineering complexity | Best suited for |
| Standard product selection | Existing size, standard felt color, and standard LED specification | Low | Projects that fit an established product platform |
| Minor customization | Felt color, CCT, wattage, cable length, or suspension height | Low to medium | Projects requiring controlled adjustments |
| Semi-custom development | Modified dimensions, output, mounting, or grouped layout | Medium | Architectural projects with defined constraints |
| Full custom development | New geometry, structure, tooling, lighting system, or assembly method | High | Branded interiors and OEM product programs |
Product categories should also be clarified early. Acoustic blades and baffles may manage exposed sound-absorbing area without providing integrated illumination, whereas acoustic lighting combines lighting and acoustic material in one fixture. Understanding the difference between acoustic blades, baffles, and acoustic lighting helps prevent a project team from comparing unlike systems.
OEM vs. ODM Acoustic Lighting: What Is the Difference?
OEM and ODM describe typical working models, not universal legal definitions. Their practical difference is how much product definition the customer provides at the start and how much development support the manufacturer contributes. The actual scope should always be recorded in the quotation, development agreement, drawings, and approval documents.

What Is Acoustic Lighting OEM?
In an OEM program, the customer normally begins with a relatively complete concept or specification. This may include drawings, dimensions, material requirements, lighting performance, component preferences, mounting details, branding, and target-market requirements. The manufacturer reviews manufacturability, converts the supplied design into a controlled production solution, produces samples, manufactures the approved configuration, and performs the agreed quality checks.
OEM is often appropriate for established lighting brands, distributors with defined product specifications, and project teams that already control the design documents.
What Is Acoustic Lighting ODM?
In an ODM program, the customer may begin with an application, reference image, design direction, basic dimensions, target market, performance brief, and commercial position. The manufacturer can contribute more broadly to concept development, structural proposals, platform modification, component selection, optical and electrical integration, prototyping, and production documentation.
ODM does not automatically determine ownership or exclusivity. Design ownership, tooling ownership, confidentiality, permitted modifications, sales territories, and exclusive rights are commercial and legal matters that should be agreed in writing before development begins.
Which Model Is Right for Your Project?
| Question | OEM | ODM |
| Who provides the initial design? | Primarily the customer | Customer and manufacturer jointly |
| Who develops the production structure? | Manufacturer engineers the supplied design | Manufacturer provides broader development support |
| Best suited for | Established brands and well-defined projects | New products and early-stage concepts |
| Customer documentation | More complete files are normally required | Work can begin with a structured design brief |
| Development effort | Often lower when files are complete | Usually higher because more design work is involved |
| IP discussion | Important | Especially important |
Choose OEM when the design intent and specifications are mature. Choose ODM when the opportunity is clear, but the product still needs engineering definition. In either case, responsibility for drawings, tests, approvals, revisions, tooling, and compliance documentation should never be left to assumption.
When Does a Commercial Project Need Custom Acoustic Lighting?
Custom development is justified when a standard fixture cannot satisfy a requirement that materially affects design, performance, installation, branding, or delivery.
The Standard Fixture Does Not Match the Ceiling Geometry
The project may require an extra-long linear pendant, a large ring, a curved assembly, repeated modules, or dimensions coordinated with a reflected ceiling plan. A project-specific arrangement using acoustic panel pendant lighting may also help when the ceiling concept depends on a defined panel proportion or composition. Feasibility still depends on structure, balance, suspension, component access, packaging, and site entry.
The Project Requires a Specific Architectural Form
A branded space may call for a logo-derived geometry, a cloud composition, a sculptural pendant array, or a repeated visual language across different room types. These concepts require more than a silhouette: the frame, felt joints, light distribution, weight, cable positions, and installation sequence must all support the intended form.
Standard Lighting Performance Is Not Sufficient
Customization may be necessary when the brief specifies output, CRI, CCT, tunable white, direct or indirect distribution, dimming, emergency integration, local input voltage, or a project control system such as DALI or 0-10V. These requirements must be reviewed together because changing the driver or output can affect space, heat, wiring, optics, and documentation.
The Interior Requires a Specific PET Felt or Brand Identity
Material requirements may involve a physical color match, a selected thickness or construction, recycled-content documentation, fire-related documents, private-label instructions, model codes, labels, or branded cartons. Physical felt samples and approved production references are more reliable than screen colors alone.
Before starting a custom program, confirm that the design benefit and expected quantity support the development effort. A visually different product is not automatically a better project solution.
What Can Be Customized in an Acoustic Lighting Project?
A capable development brief treats every requested change as part of a connected system. Increasing the fixture length, for example, may alter structural support, LED layout, driver capacity, suspension points, carton size, and installation labor. The main customization areas are below.

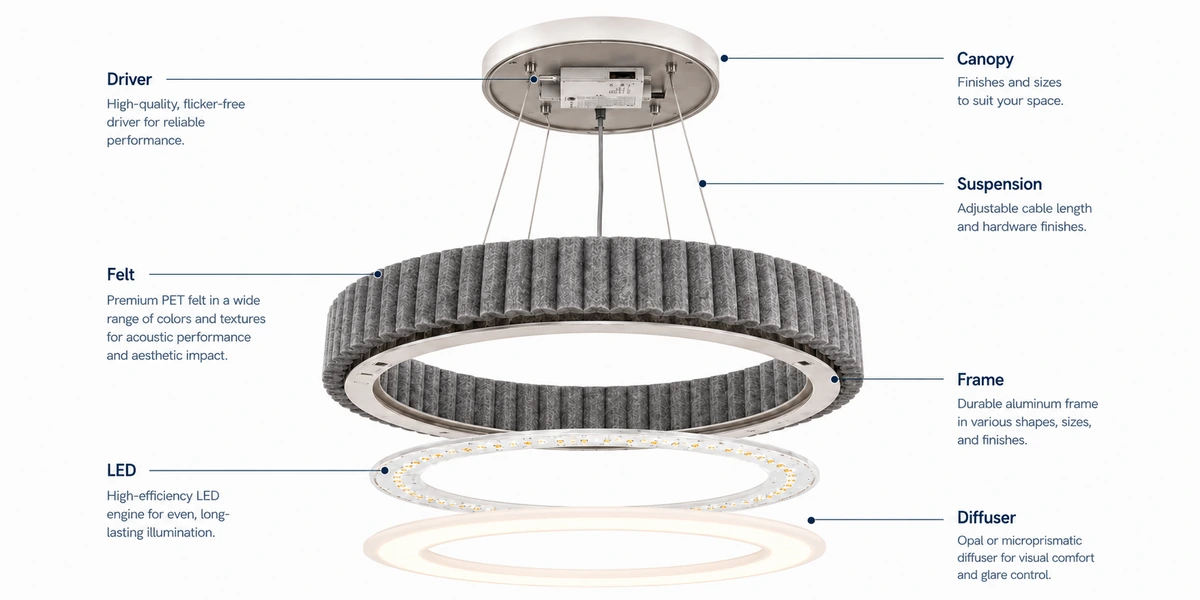

Product Shape and Fixture Dimensions
Possible forms include linear, ring, dome, panel, blade, cloud, modular, and project-specific geometries. Dimensions may cover length, width, height, diameter, felt depth, luminous opening, module spacing, and suspension drop.
Acoustic linear pendant lights illustrate how length and proportion influence a familiar format, while acoustic dome pendant lighting shows a different relationship between felt form and illuminated surface. Any new geometry must be assessed for cutting, forming, framing, LED placement, balance, packing, and access for installation or service.
PET Felt Material and Color
The brief may define felt color, thickness, density, texture, exposed edges, folds, bonded joints, recycled content, or required material documents. The project team should approve a physical reference and define how batch variation will be evaluated. Acoustic information must also be described at the correct level: material test data does not by itself prove the performance of a complete fixture or the resulting room.
LED, Optics, Drivers, and Controls
Lighting customization can include wattage, target output, CCT, CRI, beam distribution, diffuser, direct and indirect light, tunable white, uniformity, and glare-related objectives.
Driver selection may include switched, DALI, 0-10V, phase dimming, sensors, or other project controls. Compatibility among the LED, driver, voltage, wiring, protocol, thermal path, and control system should be confirmed before the prototype is approved.
Mounting, Branding, and Packaging
Mounting choices include suspension length, canopy design, surface mounting, grouped suspension, power-entry position, cable routing, and anti-sway provisions.
They must coordinate with the ceiling structure, sprinklers, HVAC, sensors, access panels, and installation sequence. Private-label programs may also require logos, model codes, manuals, barcodes, carton artwork, accessories, spare parts, and project-specific packing lists.
| Customizable area | Typical options | Main engineering impact |
| Shape | Linear, ring, dome, panel, cloud, or custom geometry | Frame, felt cutting, balance, and LED layout |
| Size | Length, diameter, depth, opening, and suspension drop | Output, strength, component space, and packaging |
| PET felt | Color, thickness, texture, edges, and construction | Appearance, forming, acoustic surface, and material documents |
| Lighting | Wattage, CCT, CRI, optics, and light distribution | Driver, thermal path, uniformity, and photometric design |
| Controls | DALI, 0-10V, sensors, tunable white, or other agreed protocols | Driver compatibility, wiring, commissioning, and documentation |
| Mounting | Cable, canopy, surface mount, or grouped suspension | Ceiling coordination, stability, and installation |
| Branding | Logo, labels, manuals, cartons, and model codes | Production documents, quantities, and approval control |

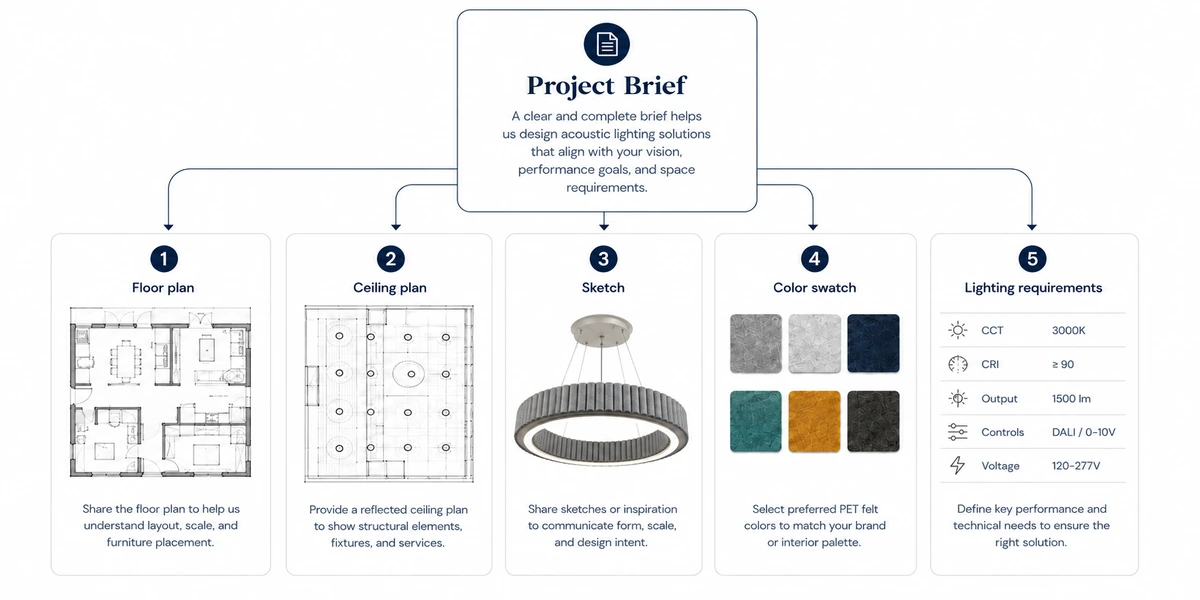

What Information Should You Provide to a Custom Manufacturer?
The quality of the initial brief affects the speed and accuracy of feasibility feedback. A concept image can communicate direction, but it cannot replace dimensions, engineering decisions, component specifications, and written approval.

Project, Room, and Ceiling Information
State the project type, room function, destination country or market, estimated quantity, required installation date, and delivery location. Provide room dimensions, ceiling height and type, the reflected ceiling plan (RCP), furniture layout, and known installation constraints.
For workplace projects, an open-plan office acoustic design reference can help frame the application, but project-specific acoustic and lighting calculations are still required. Preliminary planning may also use a guide to calculate how many acoustic lights a space may need; the final quantity should be checked against the actual room layout, light levels, and acoustic objectives.
Design and Performance Files
Send marked-up sketches, reference images, dimensioned CAD or PDF drawings, 3D files where available, renderings, and a color schedule. Define the required output or illuminance basis, correlated color temperature (CCT), color rendering index (CRI), input voltage, dimming protocol, emergency requirements, and any requested photometric data or IES/LDT files.
If a unified glare rating (UGR) target is a project criterion, provide the relevant room, layout, mounting, and calculation context rather than treating UGR as a universal fixture value.
Material and Commercial Requirements
Identify the desired felt color, thickness or construction, applicable material or fire-related documentation, and any existing acoustic calculations. Commercial inputs should include quantity, expected MOQ where relevant, target price range if one exists, prototype deadline, production deadline, packaging needs, branding requirements, and shipping destination.
Have a custom acoustic lighting concept? Submit your project brief with the drawing, room dimensions, target size, felt color, lighting requirements, quantity, destination, and timeline for an initial feasibility review.

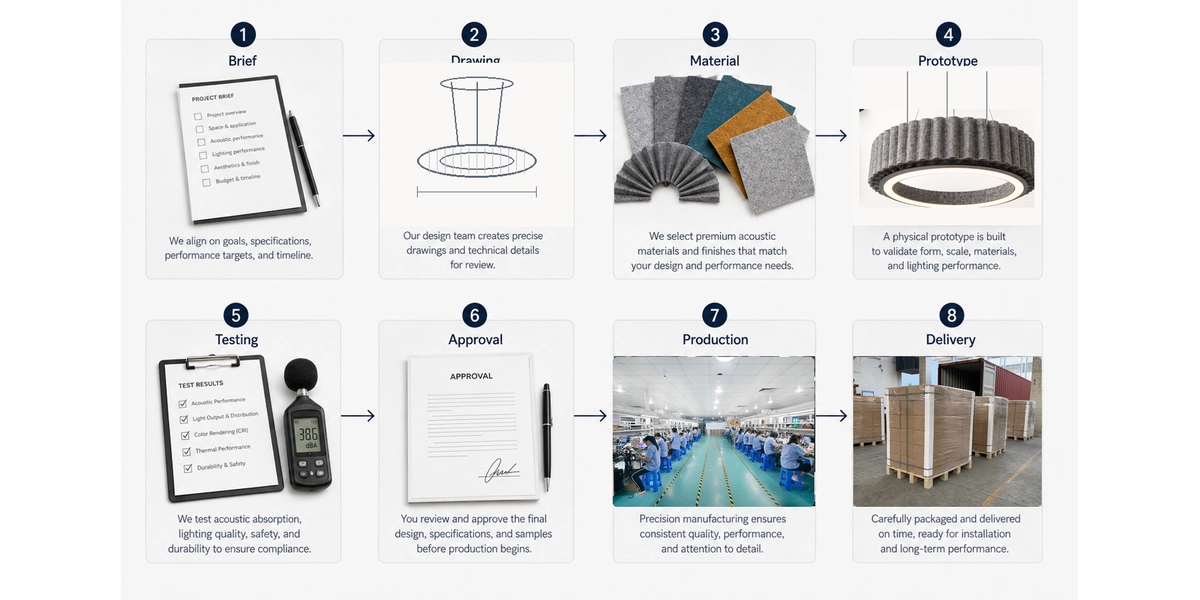

The Custom Acoustic Lighting Development Process
The development process should create a traceable path from the initial brief to the product delivered on site. Each stage needs a defined output and approval point; otherwise, an attractive sample can drift into a different production configuration.

Step 1: Concept and Requirement Review
The manufacturer first determines whether the request is a standard adjustment, semi-custom project, or new product. The review covers manufacturability, application, quantity, schedule, destination market, documentation, and missing inputs.
Early risks may include a thin structure, inadequate driver space, unstable suspension, felt forming limits, a restrictive luminous opening, oversized packaging, or insufficient maintenance access. The buyer should receive feasibility feedback, an information-gap list, a proposed direction, and a preliminary cost and timing framework.
Step 2: Engineering Design and Technical Drawings
Engineering converts the visual concept into a buildable configuration. Drawings should define overall dimensions, frame, felt construction, LED layout, driver location, thermal path, diffuser, wiring, suspension, canopy, assembly, and service access. The project team should approve dimensioned and installation information, not only a rendering.
Key approval items include power entry, suspension points, light direction, material reference, driver and control configuration, product weight, and installation interface. Every drawing should carry a revision number and date so the sample, bill of materials, quotation, and production order refer to the same version.
Step 3: Material and Component Selection
The selected components must support the agreed design and target market. PET felt decisions include construction, thickness, density, color, surface quality, cutting or forming method, and relevant documentation. The lighting package includes the LED, output approach, CCT, CRI, optics, driver, dimming, and voltage. Structural selections cover metal parts, fasteners, suspension cables, canopies, connectors, and replaceable items.
These choices should be recorded in a controlled bill of materials. The BOM connects the approved prototype to mass production and helps prevent an unreviewed component substitution from changing appearance, output, controls, or installation.
Step 4: Prototype Development
A prototype is a decision tool, not merely a visual sample. Depending on complexity, it may verify proportion, felt color, edge quality, structure, light uniformity, glare, dimming response, driver noise, installation, service access, or packaging. Simple projects may combine stages; more complex products may require separate samples.
| Prototype type | Main purpose |
| Appearance mock-up | Check size, shape, felt color, finish, and visual proportion |
| Engineering prototype | Check structure, components, assembly, balance, and service access |
| Illuminated sample | Check output, uniformity, glare-related behavior, controls, and driver operation |
| Pre-production sample | Confirm the final documented configuration before mass production |
A documented custom acoustic pendant case study shows one exhibition project moving from reference images through engineering drawings and approvals to production. The reported 5-7-day figure applies to the production stage after earlier parameter confirmation; it is not a general development or delivery promise.
Step 5: Testing and Sample Approval
Testing should match the quoted configuration and agreed scope. Lighting and electrical checks may cover power, voltage, current, output, CCT, CRI, dimming behavior, power factor, insulation, or other applicable safety items. Mechanical review may cover suspension, load-bearing components, stability, fasteners, canopy, and assembly. Appearance inspection should address felt color, edges, alignment, diffuser fit, gaps, and visible damage.
Acoustic information should identify the tested material or assembly, exposed area, and installation configuration. It should not be presented as a guaranteed room result without project-specific inputs.
A sample approval record should identify the model, dimensions, felt reference, LED, driver, controls, mounting, packaging, approval date, and drawing revision.
Step 6: Compliance and Documentation Review
The required evidence depends on the destination market, exact electrical configuration, material requirements, labeling, and project specifications. Possible deliverables include specifications, technical drawings, wiring diagrams, installation instructions, photometric files, material reports, test reports, and packaging data.
The review must identify which documents apply to the quoted product and configuration. It should not assume that every option automatically carries the same certification or supports every green-building, electrical, or fire requirement. The acoustic LED lighting compliance guide provides a useful framework for organizing these questions before production.
Step 7: Mass Production and Quality Control
Mass production is not simply a larger prototype run. The factory must control felt batches, cut dimensions, formed parts, frame geometry, LED and driver models, wiring, assembly, suspension hardware, labels, accessories, and packaging against the approved revision.
| QC stage | Main checks |
| Incoming material | Felt color and thickness, LED and driver model, structural parts, and specified accessories |
| In-process inspection | Dimensions, cutting, forming, frame, wiring, and assembly |
| Electrical test | Power, function, controls, and agreed safety checks for the approved configuration |
| Appearance inspection | Color, edges, gaps, alignment, diffuser, finish, and scratches |
| Final inspection | Function, mounting parts, accessories, labels, instructions, and revision match |
| Packaging inspection | Protection, carton, accessory separation, labels, and packing list |
Inspection criteria, sampling method, treatment of defects, and approval responsibility should be agreed for the order. For color-sensitive projects, the batch-control method and physical reference deserve particular attention.
Step 8: Packaging, Shipping, and Project Delivery
Packaging should be engineered alongside the product, especially for long, large, curved, or irregular fixtures. Decisions include fully assembled versus flat-pack shipment, edge and surface protection, moisture protection, separated accessories, carton and pallet dimensions, labels, spare parts, and installation sequence.

The logistics review should consider container loading, sample airfreight, site access, doors, lifts, storage, and installation order. Multi-location or phased projects need consistent drawing revisions, components, felt-batch strategy, labels, packing lists, and delivery sequencing. Development is complete only when the approved product can be manufactured repeatedly, identified correctly, transported securely, and installed as planned.
How Long Does Custom Acoustic Lighting Development Take?
There is no reliable universal lead time for a custom acoustic lighting project. A modification based on an existing platform may move faster than a new geometry that requires structural development, special tooling, several prototype rounds, market-specific testing, or complex packaging. The schedule also depends on how complete the initial brief is and how quickly drawings, samples, and revisions are approved.
| Development stage | Main time variables | What keeps the project moving |
| Feasibility review | Completeness of the brief, target market, quantity, geometry, and missing technical inputs | Submit the room, ceiling, product, lighting, control, quantity, destination, and deadline information together |
| Engineering design | Structural complexity, LED layout, driver space, thermal path, suspension, wiring, and service access | Review dimensioned drawings and installation details, not only renderings |
| Material and component confirmation | PET felt availability, color matching, driver selection, optics, hardware, and special finishes | Approve physical felt samples and exact component specifications early |
| Prototype and revisions | Prototype type, tooling, illuminated testing, aesthetic changes, and number of revision rounds | Combine feedback into one controlled revision list and identify decision owners |
| Testing and approval | Required electrical, photometric, mechanical, material, or configuration-specific documentation | Define the destination market and required evidence before the prototype is finalized |
| Production and delivery | Order quantity, component supply, batch control, packaging, shipping method, and site sequence | Freeze the approved drawing, BOM, sample, labels, and packaging before production |
The most dependable way to shorten development is not to skip validation. It is to provide a complete brief, make decisions against controlled drawings and samples, and avoid changing the approved configuration after production planning begins. The manufacturer should give a project-specific schedule with approval gates rather than a single number that ignores engineering and logistics.
What Affects the Cost of Custom Acoustic Lighting?
Custom acoustic lighting is priced around the final configuration and the work required to make it repeatable. Two fixtures with a similar visual size can have different costs if one uses a simple existing structure while the other needs a new frame, premium controls, special felt forming, tooling, testing, or oversized packaging. A useful quotation should separate development costs from unit, packaging, and freight costs where appropriate.
| Cost factor | Why it changes the price | Useful information for quoting |
| Product size and geometry | Changes material use, frame strength, cutting time, assembly, balance, and shipping volume | Dimensioned drawing, quantity, suspension points, and installation constraints |
| PET felt specification | Thickness, density, color, texture, forming, edge treatment, recycled content, and required documentation affect sourcing and processing | Physical color reference, material requirements, and acceptable batch variation |
| LED, optics, and controls | Output, CRI, CCT, beam distribution, diffuser, driver, dimming, emergency functions, and voltage affect the component system and testing | Target output or illuminance, control protocol, voltage, destination market, and photometric needs |
| Tooling and prototypes | Jigs, molds, cutting programs, fixtures, illuminated samples, and project-specific tests add non-recurring work | Required prototype level, approval process, and expected revision scope |
| Order quantity and MOQ | Development and setup costs are distributed across fewer units in a small run; special materials may also have supplier minimums | Trial quantity, production quantity, repeat-order forecast, and customization depth |
| Packaging and freight | Large rings, long linear fixtures, irregular forms, protective inserts, pallets, and airfreight samples can materially affect landed cost | Delivery address, shipping method, site access, flat-pack preference, and phased-delivery plan |
Do not compare quotations by unit price alone. Confirm whether tooling, prototypes, drivers, suspension kits, spare parts, documents, packaging, freight, duties, and on-site assembly are included. The lowest initial price can become expensive if the scope is incomplete or the product cannot be installed as planned.
How to Select a Reliable Custom Acoustic Lighting Manufacturer
A custom acoustic lighting manufacturer should be evaluated by the evidence it can produce for your configuration, not by broad claims about experience or quality.
The strongest candidate can explain design limits, identify missing information, document approvals, and show how the approved sample will be reproduced in production.

1. Acoustic Material Expertise
Ask how PET felt thickness, density, exposed area, forming, edges, color batches, and mounting affect the product. The manufacturer should distinguish available material or assembly test data from the performance of a complete luminaire and from the result inside a particular room.
2. LED Lighting Manufacturing Capability
The team should be able to explain the LED module, optical system, driver compatibility, thermal management, dimming behavior, wiring, photometric validation, electrical checks, and service strategy. Felt fabrication alone does not establish capability to engineer an integrated luminaire; the supplier should also document its lighting, electrical, thermal, and control competence.
3. Engineering and Drawing Capability
Request dimensioned product drawings, installation details, suspension points, electrical entry, wiring information, product weight, and version-controlled revisions before approving production. Renderings communicate appearance; they do not define a manufacturable product.
4. Prototype Capability
Confirm whether the supplier can build the right type of sample, illuminate it, record its component configuration, manage revisions, and retain an approved production reference. Complex projects should normally validate more than color and shape.
5. Quality-Control System
Ask how incoming felt, components, cutting, frames, LED assemblies, wiring, output, appearance, labels, accessories, and packaging are checked. The answer should include batch and version control, acceptance criteria, inspection records, and a process for nonconforming units.
6. Production and Delivery Capacity
Review realistic capacity, component availability, packaging development, export experience, split shipments, labeling, spare parts, and delivery sequencing. A large fixture is not successfully delivered until it can pass through the site, reach the ceiling, and be installed in the correct order.
7. Honest Technical Communication
A reliable manufacturer states what has been verified, what still requires testing, and what cannot be promised before the final configuration is known. It should also raise conflicts between appearance, light output, structure, controls, installation, compliance, budget, and schedule early.
| Evaluation area | What to ask for | Warning sign |
| Materials | Physical felt samples, specification, batch-control method, and applicable reports | A screen color or generic material claim is treated as final approval |
| Lighting system | Exact LED, driver, optics, voltage, controls, thermal approach, and test scope | Components are described only as “high quality” or can change without approval |
| Engineering | Dimensioned drawings, installation information, weight, wiring, revision number, and date | Only a rendering or unmarked sketch is provided |
| Prototype | Illuminated sample plan, approval record, revision process, and retained reference | Production is proposed before representative validation |
| Compliance | Documents tied to the destination market and quoted configuration | One certificate is presented as covering every product and market |
| Quality control | Incoming, in-process, functional, appearance, batch, and packaging checks | No written criteria, records, or configuration control |
| Delivery | Capacity, component plan, packing method, shipment sequence, and site constraints | Lead time is promised before requirements and approvals are understood |
Once these questions are defined, you can compare them with Feltlite’s custom acoustic lighting capabilities and request evidence relevant to the product you are actually considering.
Why Project Teams Work With Feltlite?
Project teams work with Feltlite when one partner needs to coordinate the acoustic material, lighting, structure, controls, sample, and delivery plan together.
- That makes the early engineering review more useful because design limits, heat, wiring, mounting, and control compatibility can be checked before approval.
- It also makes sample review easier because felt color, finish, light output, proportion, and installation details are evaluated against the same approved configuration.
- For buyers, the practical value is fewer handoffs, clearer ownership, and less rework before mass production.
- If you are comparing suppliers, send the concept or drawing, dimensions, felt color, lighting and control requirements, quantity, market, and deadline to request an OEM/ODM Project Review.
- That is the fastest way to confirm feasibility before you commit to tooling and production.
- A coordinated review helps keep approvals, samples, and production aligned.
- If your team needs that kind of coordination, Feltlite can review the concept before you move into samples or tooling.
Custom Acoustic Lighting Manufacturer Checklist
Use this checklist when preparing an inquiry, approving a sample, or comparing manufacturers. Not every project needs the same document, but every applicable requirement should have a clear owner and approval record.
| Project item | What to confirm before production |
| Application and market | Space type, destination country, indoor conditions, applicable project requirements, and intended use |
| Final form and dimensions | Overall size, modules, openings, felt depth, clearances, weight, and dimensional tolerances |
| PET felt | Specification, physical color sample, thickness, density, finish, edge treatment, forming, and batch plan |
| Lighting | Target output or illuminance, CCT, CRI, optics, distribution, diffuser, uniformity, and photometric file needs |
| Driver and controls | Driver model, input voltage, DALI/0-10V/other protocol, wiring, emergency function, and commissioning responsibility |
| Mounting | Suspension length, canopy, fixing points, power entry, ceiling interface, stability, access, and installation sequence |
| Engineering files | Approved product drawing, installation drawing, wiring information, revision number, date, and BOM reference |
| Prototype approval | Sample type, illuminated checks, changes, acceptance record, approved configuration, and retained reference |
| Testing and documents | Configuration-specific electrical, photometric, mechanical, material, labeling, and market documents required by the project |
| Commercial terms | Development scope, tooling, MOQ, sample cost, unit price, payment terms, lead-time basis, and change responsibility |
| Packaging and delivery | Assembly format, protection, accessories, labels, carton or pallet data, freight method, site access, and phased shipment |
| Support | Installation guidance, spare parts, replacement components, warranty terms, and post-delivery contact process |
Conclusion
Choosing the right custom acoustic lighting manufacturer means looking beyond product appearance or price. A reliable OEM/ODM partner should combine PET felt, lighting performance, engineering, prototyping, compliance, quality control, and delivery into one controlled development process.
For a successful OEM/ODM acoustic lighting project, define your specifications early, approve drawings and samples carefully, and confirm the final configuration before mass production. The right manufacturer should not simply make a custom fixture—it should turn your design concept into a reliable, repeatable, and project-ready acoustic lighting solution.
